Yantai Tianma Xiangcheng

01.08.2023 01:08
Visits:886

Yantai Tianma Xiangcheng

Project Management
  • Location

    Yantai

  • Client

    Yantai Tianma Industrial Development Co.

  • Engineering scale

    Full facade curtain wall high-end residential project

  • Service items

    Engineering management


Yantai Tianma Xiangcheng Phase IV

Tianma Xiangcheng is located in Yantai Development Zone, with a vast coastline and dense forests. The four-phase project, which covers an area of 194,000 square meters, aims to become a boutique work that gives a new meaning to the concept of human settlements, relying on the two product formats of high-rise and garden villas to ensure the purity of the owners ' circle. Among them, the area of high-rise doors and windows and external walls is about 205100 m2, and the area of foreign house doors and windows and external walls is about 48270 m2.

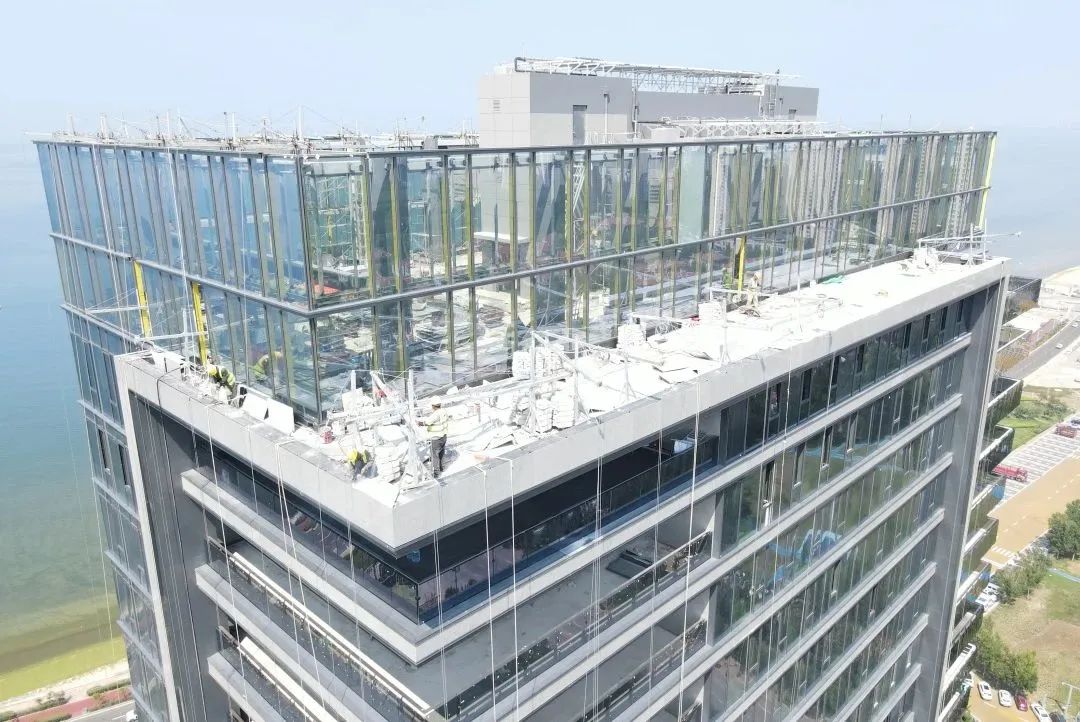

▲  Project effect diagram


The main colors of the project are cold stone, gray aluminum plate and blue-gray low-e hollow glass, partially interspersed with imitation copper aluminum plate, creating a delicate and advanced public building facade. The overall building structure is a frame shear wall structure. The external wall system covers aluminum alloy doors and windows, roof steel structure, high-rise glass windows, stone curtain wall, aluminum plate curtain wall, system doors and windows, outdoor railings, grille systems, fire barriers, etc. Every process and every detail are set to a high standard, showing the quality of Tianma urban mansion in an all-round way.

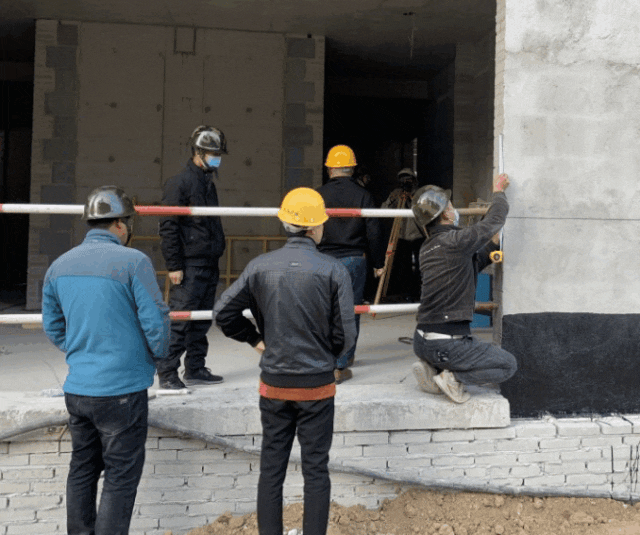

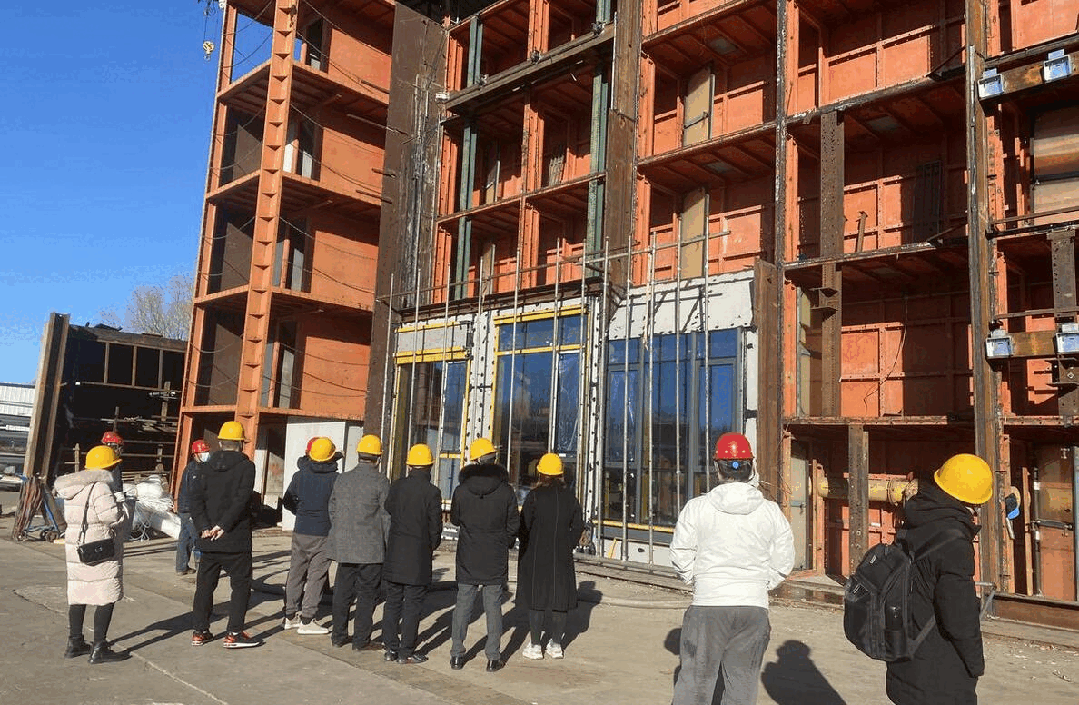

▲  Slide left and right to view the project reality map


From design specifications to quality requirements, from structural safety, construction quality, to the building 's ability to resist special environments, B & J 's services fully cover the entire project construction cycle. We record, analyze and predict possible construction hazards from various angles, and pre-control them in advance to ensure the final landing quality of the project.


1




In-depth drawing audit


The project did not move, the drawings first. For engineering construction, construction drawing review is an indispensable part. Through careful inspection, we provide a professional analysis of the direction of the drawings, so that the participating parties can grasp the characteristics and difficulties of the project in time, and find and solve problems in time. In the drawing review stage, Bijie will review the drawing integrity, processing method feasibility, calculation book, landing effect and other contents one by one from the perspectives of cost optimization, safety guarantee and process review to ensure the final presentation of construction drawings and project effects.



2




Recruitment Resource Assessment

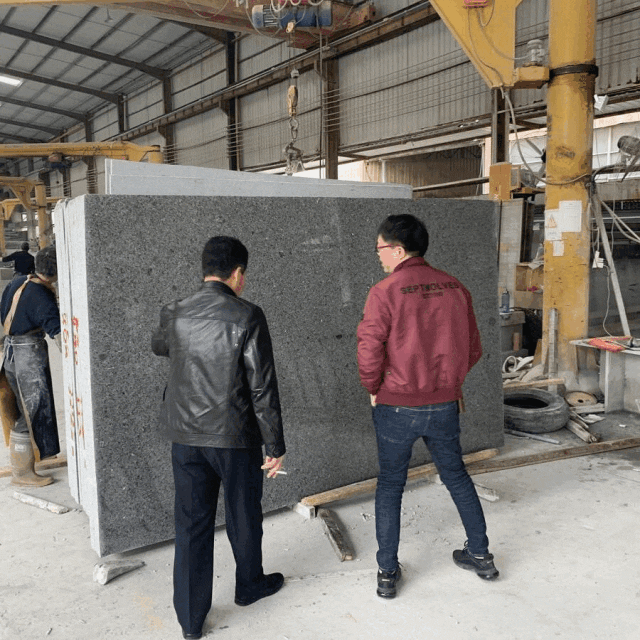

On the premise of assisting Party A to avoid contract risks and with the goal of improving the quality and quality of deep processing of profiles, Bijie will investigate and form an investigation report on the procurement resources required by Tianma project from the aspects of its real quality, factory scale, processing capacity and supply system. Through the form of organized process procurement, we track the whole process of supply in real time, ensure that there is no shortage of reviewers in each link, so as to help customers review resources.



3




Professional model evaluation


Making a visual template VMU allows architects to intuitively verify the tone, texture, and proportion of the material they choose, and how the overall state in the actual place is presented. Through the production of the visual template, Party A can understand some details of the structure and performance, and can put forward suggestions for improvement on the design drawings or the deficiencies shown in the installation process. This, to a certain extent, assists the owner to make quality and cost-related decisions, and avoids the inability to guarantee the design effect due to rework.



4




Product performance testing


The doors and windows of the fourth phase of Tianma Xiangcheng adopt the German first-line brand Schüco Schüco, and also use industry cutting-edge products to highlight the top value in curtain walls such as aluminum alloy / glass / stainless steel. In order to test whether the use function of doors and windows meets the requirements, Bijie will carry out strict tensile inspection and sealing test on Schüco sliding doors and system windows. In order to more objectively reflect the performance of the curtain wall, we will check the design requirements of the four-property test drawings, the four-property test process, the specification compliance, and the consistency between the installation plate and the drawings.



5




construction schedule control


Based on the overall progress requirements of the project, Bijie formulates the overall control plan of the project, and then scientifically decomposes it into weekly specific work arrangements. In the five-dimensional integrated plan of curtain wall construction, we carry out construction control from the dimensions of design tracking, procurement progress, supply cycle, processing plant capacity, transportation and delivery, on-site installation, and review the correction every week. In the realization of the progress goal, Bijie reasonably sets the node goal according to the project development plan, establishes the guiding principle for the construction control, and deeply combines with the data and visual feedback mechanism, so as to facilitate the efficient study and judgment of the construction status.


6




Process dynamic acceptance


At each stage of on-site construction, Bijie will arrange engineers to inspect in real time. In view of the risk points found in the inspection process, we put forward the corresponding rectification suggestions, and continue to follow up the completion of the rectification. In order to achieve the goal of ' zero leakage ' of the building facade, Bijie carried out 100 % water spray test on the curtain wall and doors and windows of the project. The engineers observed and inspected the site, analyzed the hidden danger of leakage and put forward the measures to repair the leakage. In the follow-up, we will continue to track the rectification and finally achieve the effect of closed-loop processing.



7




construction quality control


At the level of engineering quality control, Bijie will dismantle the construction process and carry out the whole process quality management from the key points of material inspection, process inspection, process template, inspection and testing. We monitor all kinds of construction schemes reported by construction units, supervise and supervise the approval of the general contractor and the supervisor, and supervise the implementation of expert demonstration in curtain wall subcontracting for schemes that need expert demonstration. In the process of on-site construction, we guide the material selection, data preparation, inspection and inspection of the curtain wall unit, prepare the project weekly report and quality inspection report on time, find and solve the practical problems encountered in the construction in time, and escort the quality of the Tianma project.



8




Completion transfer management

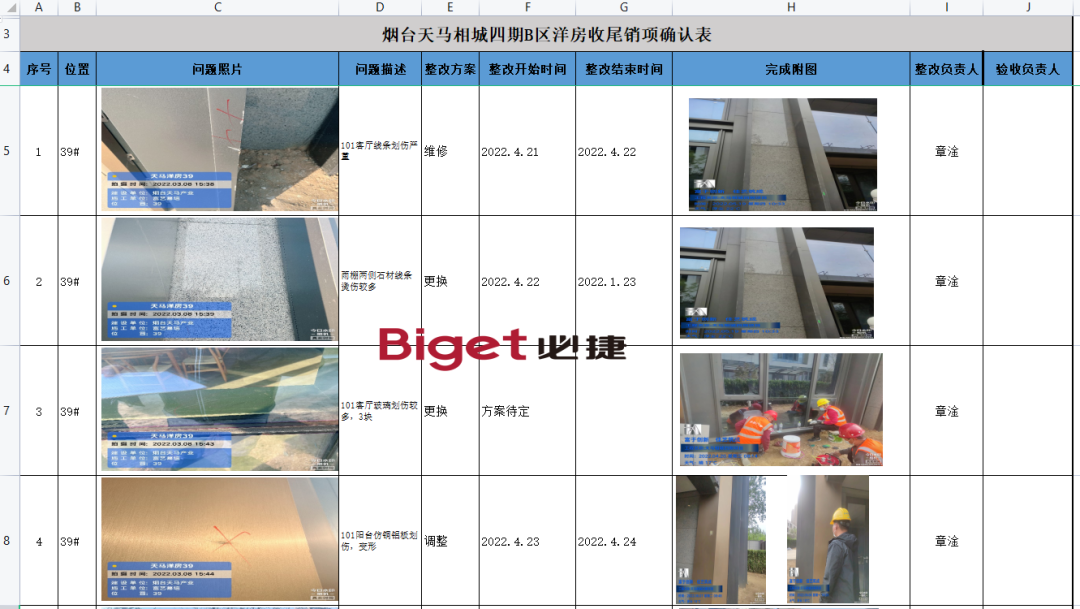

In the stage of completion and delivery, we will implement the actions of process control, schedule cancellation, quality cancellation, transfer of property, etc., check and review the problems in construction one by one, and form a tracking table of final cancellation items to ensure the high quality and high standard delivery of the project. We take the curtain wall construction quality and use function as the inspection standard, and check the performance realization and appearance status of each household in the building. In the process of inspection, Bijie timely recorded the problems found, long tail tracking, technical support and handed over to the property management.



9




Promote the establishment of a refined management system


Through systematic training and on-site guidance, we can help customers to establish a perfect quality management system and formulate a scientific ' refined project quality management method ' that is in line with their own enterprise characteristics. At the same time, it lays a solid foundation for new projects in the later period, improving construction efficiency and improving project quality !

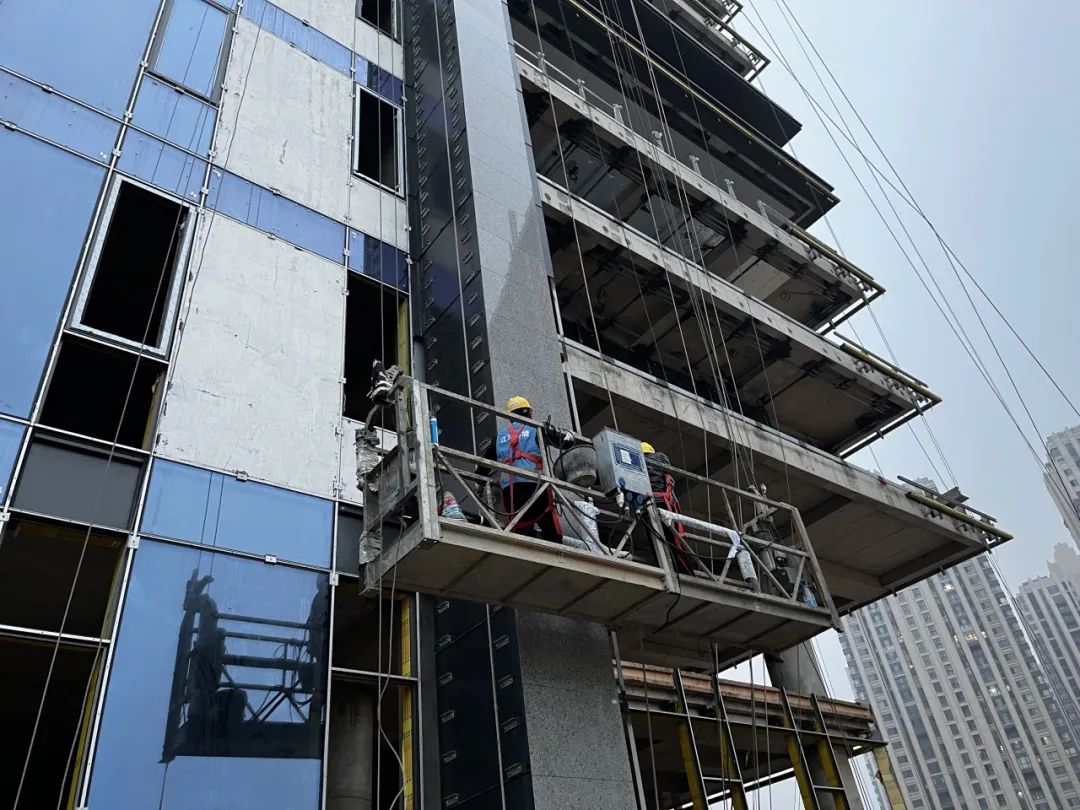

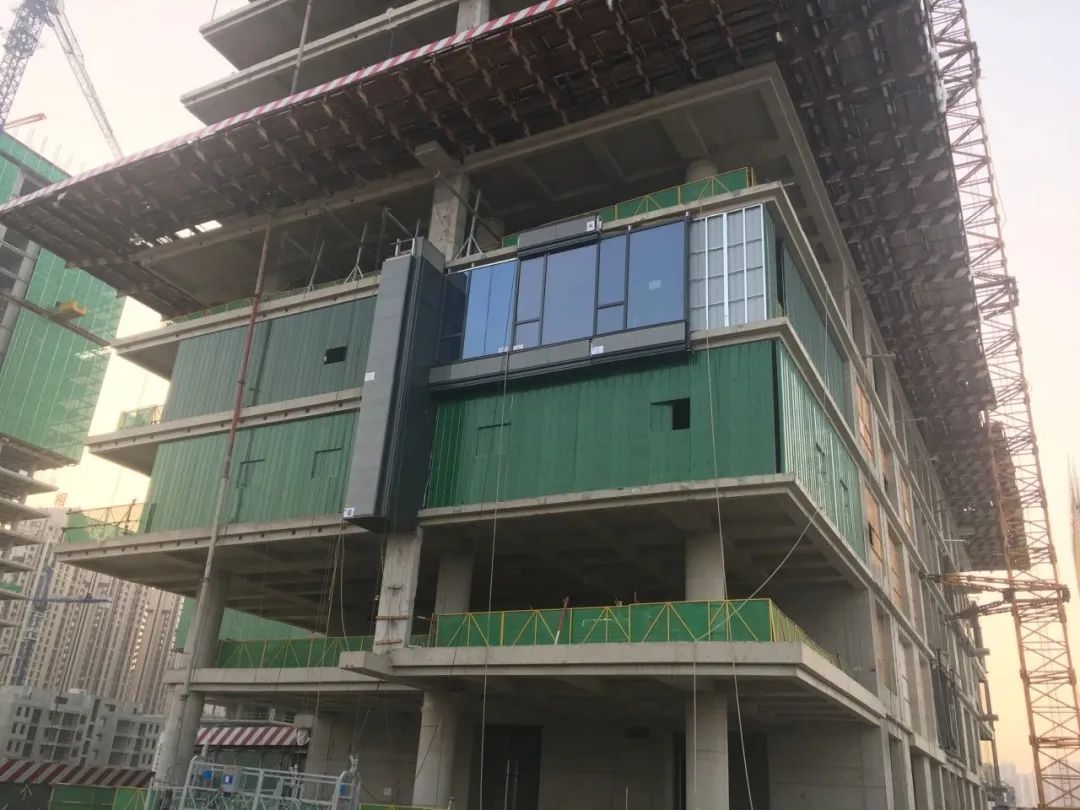

▲  Slide around to see the current status of the project


In this project, Bijie provides multi-dimensional one-stop services from construction drawings, construction quality, to technical support, schedule control, delivery management and so on. At present, the Tianma project has entered the later stage of construction, the basic construction of the outer facade is completed, and the curtain wall is gradually being delivered.


The quality management of construction projects is related to the safety and interests of owners after the delivery and operation of houses. Continuously improving the quality of building facades and creating value for customers is BIGET 's unswerving pursuit. We will continue to provide professional and considerate services, create high-quality projects with the heart of craftsmen, and create a beautiful city with customers.
